Texas filings put a $2.08 billion price on the Google campus Crusoe and Google won't number

Crusoe's announcement named Google's campus but skipped the numbers. Texas licensing filings price at least $2.08 billion of construction, and the receipts set up a power-strategy duel with Fermi one county over.

Vincent JiangVincent Jiangtwo-minute read
Share
Tall white wind turbines in a dry farm field under a blue sky in the Texas Panhandle
1 / 6Slide 1 of 6

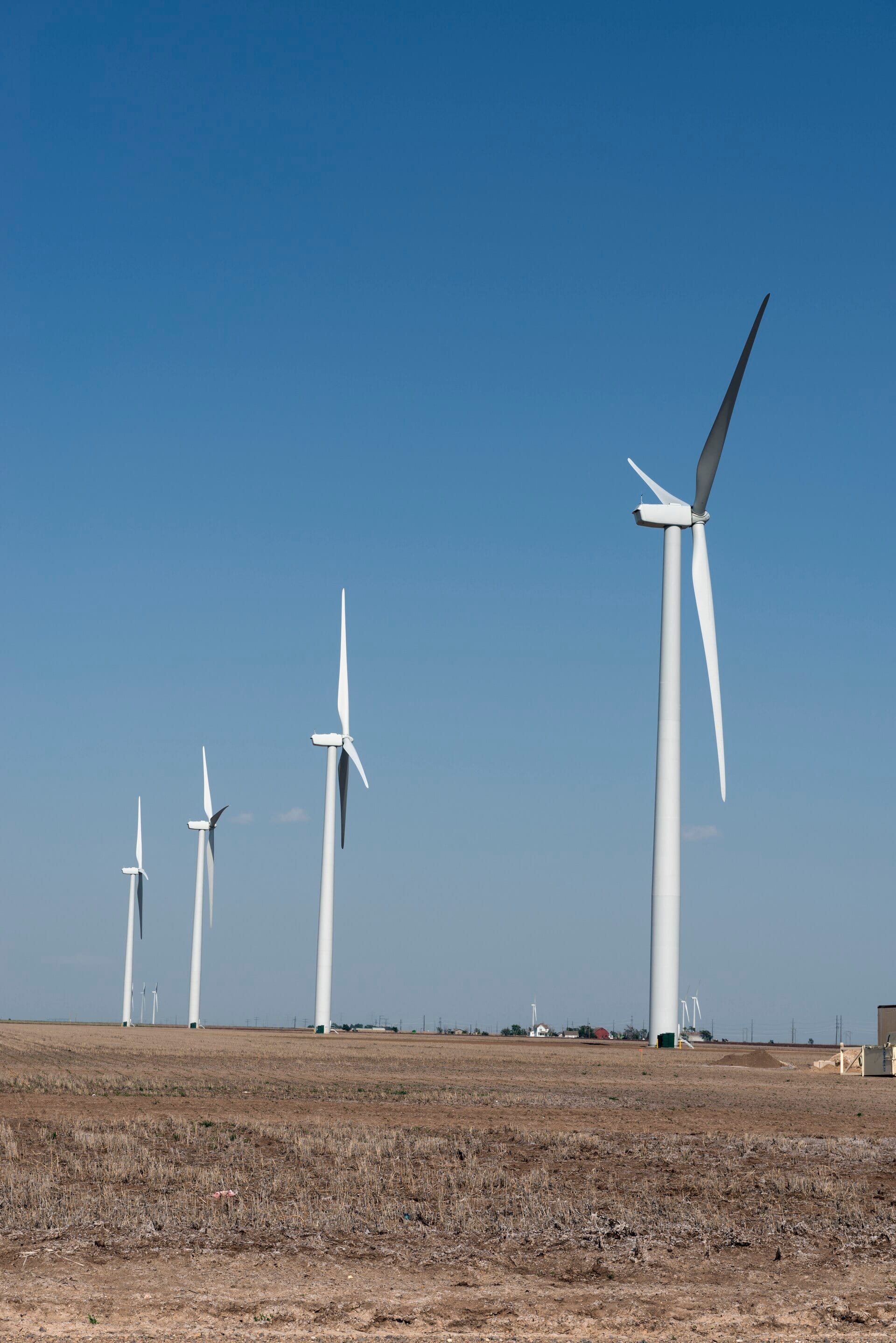

Part of a large wind farm in rural Carson County, Texas, one county over from Crusoe's Armstrong County campus and home to Fermi's Project Matador power island. Crusoe's campus connects directly to Serena's Goodnight wind farms.

Crusoe$26.61B — Crusoe, private, latest valuation $26.61B named itself developer of Google's AI data center campus in Armstrong County, Texas, outside Amarillo, in a 28 September 2026 announcement 1. The release says plenty about clean energy and nothing about size or cost: no IT capacity, no investment figure 13. The price tag exists anyway, buried in Texas licensing records.

Green highway sign reading Claude, City Limit, Pop. 1313, in front of trees
Claude, Texas, population 1,313 by its city-limit sign, is the town at whose address the campus is filed: 10001 Lima Road.Billy Hathorn at en.wikipedia

The filings do the talking

Texas Department of Licensing and Regulation filings for the campus at 10001 Lima Road in Claude, owned of record by GN DC1 LLC with HKS as design firm, identify six data center buildings and put estimated construction costs at at least $2.08 billion across five of them 2. Building 1 registered at an estimated $292 million with an August 2025 construction start; Building 2, roughly 484,954 square feet, carries $500 million in a later filing for four data halls; Buildings 3, 4 and 5 each come in near 805,000 square feet, with $500 million estimates on Buildings 3 and 4, Building 4 slated for completion in March 2027 2. Building 6, another 805,000-square-foot hall, carries an estimated July 2027 completion date 2. Neither Crusoe nor Google has disclosed the project's total investment 13.

Four costed buildings itemize $1.79 billion of the $2.08 billion filed for the campus

$0M$500M$1,000M$1,500M$2,000M$2,500MBuilding 1$292MBuilding 2$500MBuilding 3$500MBuilding 4$500MAll five costed filings: at least $2.08B
Data
Value
Building 1$292M
Building 2$500M
Building 3$500M
Building 4$500M
Estimated construction costs in Texas Department of Licensing and Regulation filings for the campus at 10001 Lima Road, Claude, in millions of dollars. Buildings 5 and 6 carry no estimate in the cited records; the five costed filings total at least $2.08 billion.2

Google pays the capex, Crusoe executes

The receipts matter for who carries the risk. Google pays the capex; Crusoe executes, with more than 5,500 skilled laborers on site daily and a June 2025 groundbreaking, promising the "same swift pace" it set in Abilene, where it is building two more campuses 12. Developer of record on a hyperscaler site is a step up from capacity seller.

Two power models, one county apart

The campus connects directly to Serena's Goodnight 1 wind farm, operational at 265.5 MW, and Goodnight 2, another 265.5 MW under construction that Crusoe says its development catalyzed; surplus power flows back to the grid 1. Cooling is closed-loop and non-evaporative, limiting water use to kitchens 12.

In neighbouring Carson County, Fermi's Project Matador takes the opposite bet: a private power island of gas, solar, nuclear and batteries behind the meter, with NAES hired on 28 September to run its turbine fleet 2. The contrast lands in an ERCOT queue holding 474 GW of connection requests, 90% from data centers, now under a governor-ordered verification audit 3. A wind-linked campus that feeds the grid in surplus hours depends on audit rules still being written; a behind-the-meter island does not queue for them at all. Which model gets its interconnection papers first is the watch-item, and it is decided in Austin, not Claude.

Get Data Center by email, free

Who is building AI's data centers, and who is paying for them. In our daily email, every weekday.

Reader comments

0 comments

    More in Data Center

    All in this topic →

    Data Center

    Riot Platforms must refinance $20.8 million drawn on a $573 million Rockdale bridge by December 31

    The Rockdale bridge, and the Corsicana project-debt raise behind it, are the first market-priced test of Anthropic's $37 billion of rent, the worry behind Keefe, Bruyette & Woods' November 11 downgrade.

    Data Center

    Ford won't force AI data centers on Ontario cities that say no, stranding Prologis's 40-megawatt project

    Ontario's premier said he would rather respect a city's freeze than override it, a day after Prologis and Montcrest appealed Mississauga's ban to the Ontario Land Tribunal. The stance strands a 40-megawatt project in a year-long tribunal queue and lands on Prologis shareholders, who own a 5.8-gigawatt data center pipeline.

    Data Center

    Fastly jumps 12.6% on a Comcast deal built for GTA VI's 212 GB launch-day download

    Shares closed up 12.6 percent at $17.90 on a launch-day partnership that names no price. The quarter underneath leans on download traffic Fastly itself calls one-off, and February's report separates the game from the business.

    Data Center

    Arista Networks launches edge routers using up to 60% less power as supplier commitments hit $11.4 billion

    At SC26, Arista pushed its routers out of the data center toward users, promising up to 60% lower power than rival edge platforms by building on 5-nanometer Broadcom silicon. The bet lands on a balance sheet carrying $11.4 billion of supplier commitments and a gross margin already sliding, so the edge must arrive before the parts bill does.

    Data Center

    Lenovo posts record $30.2 billion revenue and a $640 million loss on Alat warrants

    The record quarter is real, and so is the loss: a $1.9 billion non-cash mark on the warrants Lenovo sold with its $2 billion Saudi convertible bond deal. Shareholders now price one number the release does not settle, whether a record 9.6% server margin survives the cycle.

    Data Center

    Akamai says it is turning away 2027 cloud business for lack of power

    Akamai's cloud unit is turning away 2027 customers because it cannot power the machines, while the line renting compute to Anthropic runs at $109 million a quarter against a 2027 guide of up to $1.3 billion. Anthropic, the anchor tenant on the backlog, begins trading on Nasdaq today.

    Subscribe to TheInference for free
