Washington can now order Chinese inverters off the US grid, and the repair takes 128 weeks

DOE closed comments on October 9, 2026, on the emergency order that reaches the Chinese-brand inverters already installed on America's solar fleet, more than 70 GW of them. No kill switch is proven; the 128-week transformer queue is.

Vincent JiangVincent Jiang · 3 min read
Share
A grid-connected solar inverter cabinet at a US solar farm
1 / 6Slide 1 of 6
A grid-connected inverter cabinet at a US solar farm. The DOE emergency order reaches the Chinese-brand inverters already installed on more than 70 GW of America's solar fleet.

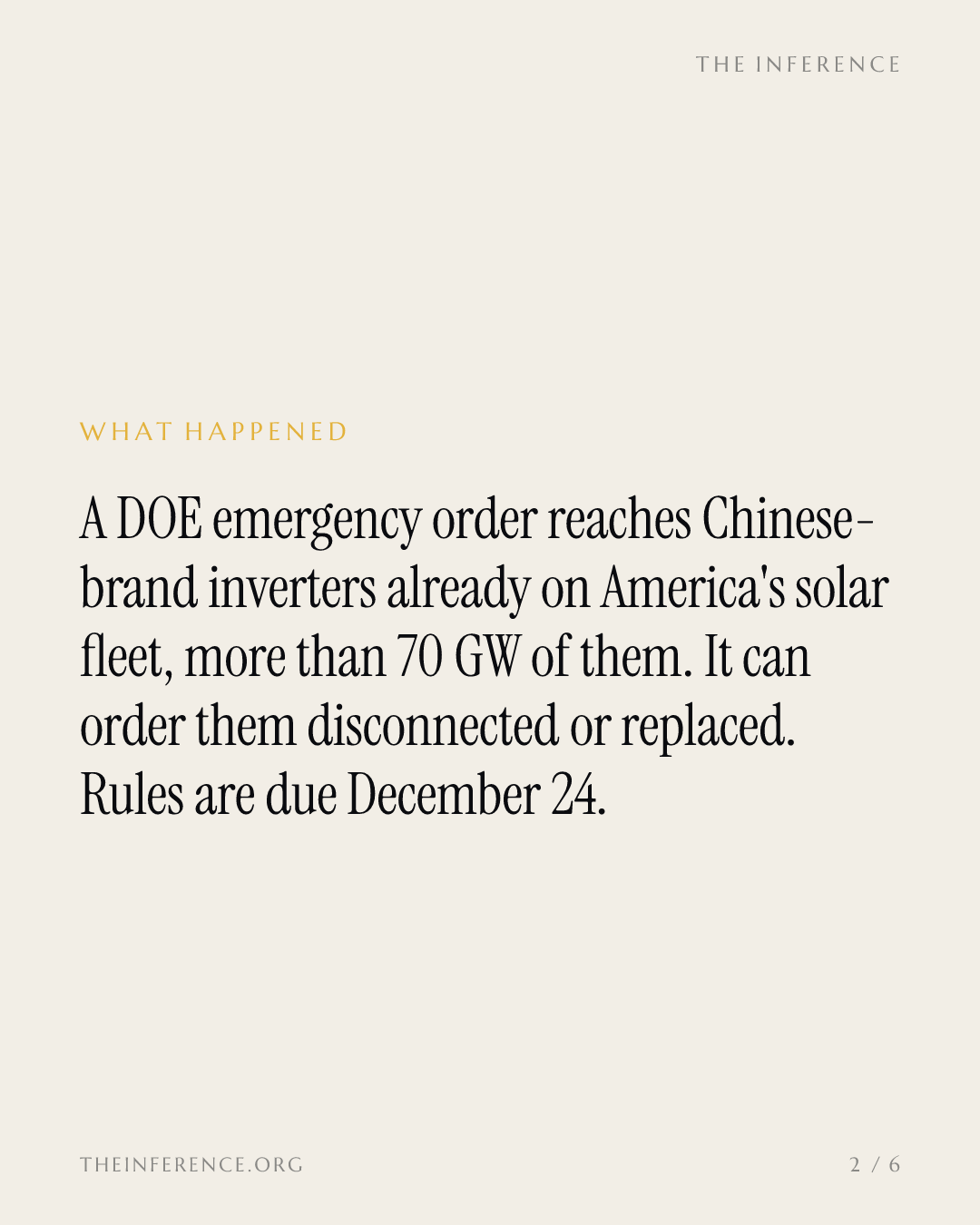

The Department of Energy closed the comment window on October 9, 2026, for implementing Executive Order 14421, the bulk-power national emergency President Trump declared on August 26 1. Its text names "data centers, artificial intelligence, and defense production" as why US dependence on reliable power keeps deepening 1.

The order revives an emergency that lapsed in 2021 2. It covers bulk-power equipment at 69 kV and above, from substation transformers to grid-connected inverters 12. It lets the Energy Secretary impose conditions on foreign equipment already in service, up to "disconnect, replace, or remove" 1. The docket drew 131 comments; under the order's 120-day clock, rules are due by December 24 13.

The order that reaches installed equipment

Under that authority sits a decade of the cheapest compliant hardware money could buy. Chinese-headquartered makers delivered more than 70 GW of commercial and utility inverters to US solar plants over the last decade 2. They hold about 60 percent of that segment 2. No US interconnection is built to ride through more than 3,875 MW of sudden loss 2.

A DNV study for Europe's solar industry says losing more than 10 GW would "most likely trigger a cascading outage" 2. Strider's floor of high-risk Chinese equipment runs 5.4 GW across 66 solar sites in 22 states 2.

Chinese-brand inverter deliveries dwarf what US grids are built to lose

0 MW20,000 MW40,000 MW60,000 MW80,000 MWChinese-brand inverters, 10-yr deliveries70,000 MWRoughly 18 times the largest design lossStrider high-risk sites5,400 MWEast design loss3,875 MWWest design loss2,918 MWTexas design loss2,805 MW
Data
Value
Chinese-brand inverters, 10-yr deliveries70,000 MW
Strider high-risk sites5,400 MW
East design loss3,875 MW
West design loss2,918 MW
Texas design loss2,805 MW
Values in megawatts. NERC 2025 resource loss protection criteria, the sudden loss each interconnection must survive; Strider count of capacity at US solar sites using equipment from Chinese makers it rates high-risk; Wood Mackenzie ten-year deliveries of Chinese-headquartered commercial and utility inverters, a floor above 70,000 MW. Exposure is not proven remote control.2

No proven switch, documented reach

No kill switch has been shown 2. A May 2025 Reuters report, resting on unnamed sources and naming no manufacturers, described undocumented cellular radios inside some Chinese inverters 24. A November 2024 remote message stopped Deye-made inverters sold as Sol-Ark in the US; Deye said "a few" gray-market units were affected, with no human intervention 2. Sungrow says its US-bound inverters lack remote functions, and the Dutch economy minister calls hidden hardware "highly unlikely" 2.

Policy moved anyway. A July national-security determination put new foreign inverter models on the FCC's Covered List 5. It is the latest in a series of US actions that includes the Hikvision and Dahua surveillance-equipment bans 5. The FCC narrowed the entry on August 20 to utility-interactive inverters with remote communications 6.

The repair is the chokepoint

If the December rules order swaps, the binding constraint is the transformer queue. Wood Mackenzie put power transformer lead times at 128 weeks in the second quarter of 2025 2. Prices are up 77 percent since 2019, and a single unit can cost $10 million 2.

The money is already moving there. GE Vernova's+0.37% — GE Vernova, up 0.37 percent today Electrification equipment backlog hit $41 billion in the second quarter, up 69 percent, with $2.7 billion of data-center orders booked in the quarter alone 7.

GE Vernova's revenue has climbed as grid-equipment demand builds

$0B$5B$10B$15BQ2 '24Q4 '24Q2 '25Q4 '25Q2 '26$11.1B
Data
Revenue
Q1 '24$7.26B
Q2 '24$8.2B
Q3 '24$8.91B
Q4 '24$10.56B
Q1 '25$8.03B
Q2 '25$9.11B
Q3 '25$9.97B
Q4 '25$10.96B
Q1 '26$9.34B
Q2 '26$11.1B
GE Vernova quarterly revenue in billions of US dollars, from its SEC filings, retrieved 10 October 2026. The company's Electrification equipment backlog hit $41 billion in the second quarter of 2026, up 69 percent, with $2.7 billion of data-center orders booked in the quarter.10

The market already split this trade

The market split this trade before the docket closed. The day after the window shut, NOARK, the North American brand of Shanghai-listed Zhejiang Chint, pitched switchgear to data-center builders at the Yotta 2026 show in Las Vegas 89. TD Cowen called the FCC move "kind of a non-event"; Jefferies saw "minimal impact today" but a "long, gradual shift in market share" toward Western suppliers 2.

SolarEdge jumped 8 percent on an upgrade tied to the curbs; Sungrow, at 15 to 20 percent of revenue from the US, expects that business to shrink gradually 2. The Chinese bid runs through Chint: first-half revenue up 28 percent to RMB 38.06 billion, about $5.7 billion 9. The low-voltage segment carrying NOARK grew just 3.6 percent, the slowest slice of a solar-heavy listing 9.

December writes the who-pays

The rules due December 24 decide whether installed gear comes out, and how fast, against a 128-week transformer queue 12. Someone will pay for hardening and spares, and utilities usually pass those costs to customers through rates 2. The trade here is the replacement bottleneck, not the cheap gear. The kill switch is a hypothesis; the repair schedule is a fact.

Deepdive

AI-generated from this story and its cited sources. Not investment advice.
