Oracle Bought the Option to Pay Late. Bloom and Blue Owl Carry the 2028 Date
Oracle filed contract language on 24 September that lets it defer payments if Project Jupiter misses its 2028 online date, then reaffirmed the 2.4-gigawatt order that notice hedged against. Five sessions of tape show who underwrites the date.
Vincent Jiangthree-minute read
The marker: Bloom gets the week back in one session

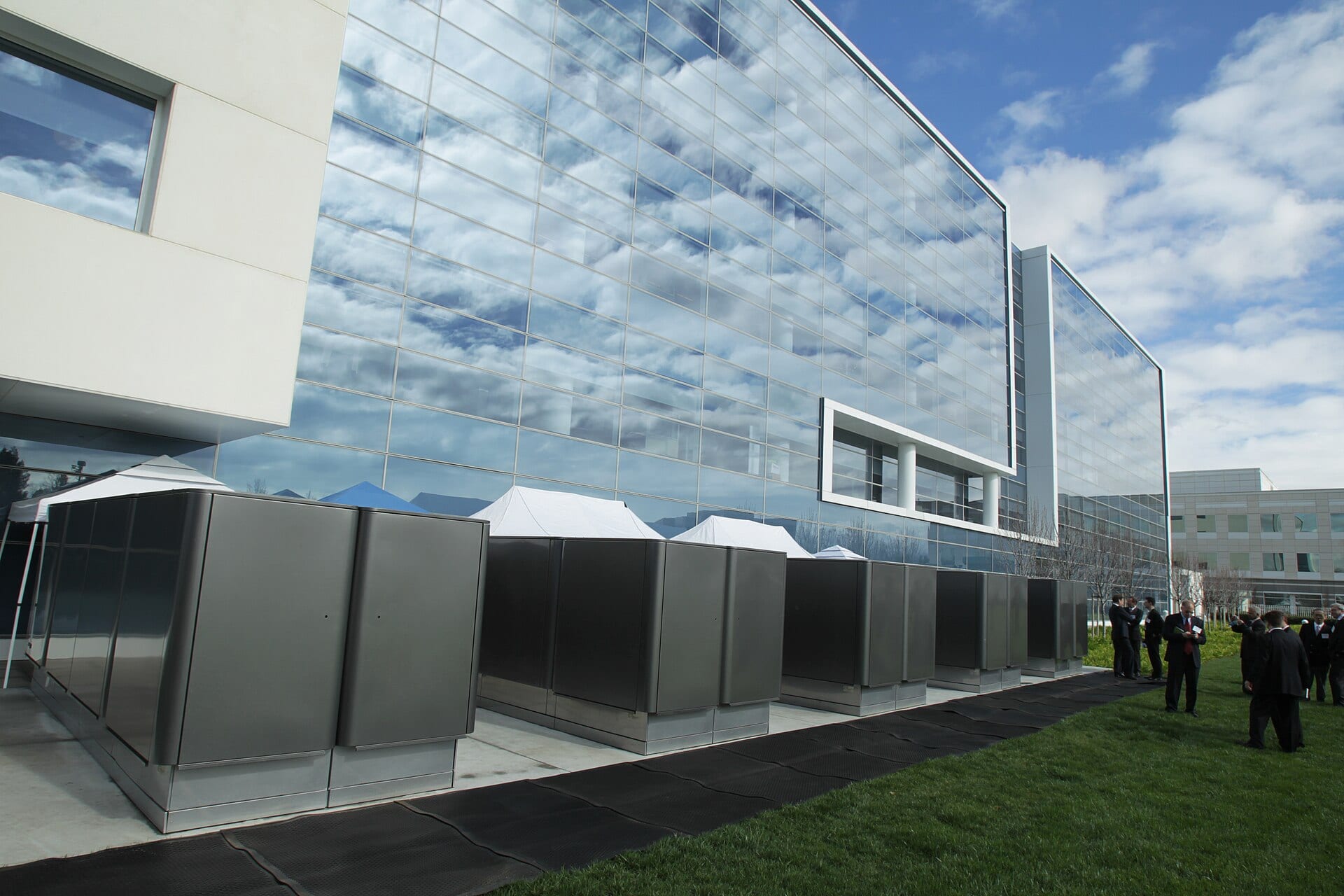

Bloom Energy−13.43% — Bloom Energy, down 13.43 percent today rose as much as 13% on 29 September after Oracle−6.58% — Oracle, down 6.58 percent today reaffirmed the 2.4-gigawatt fuel-cell order behind Project Jupiter, the AI campus rising near Santa Teresa, New Mexico 15. The session also credited a second document: Bloom has taken another 158,000 square feet in Fremont, California, nearly the size of the 164,000-square-foot plant it already runs there 2. Oracle, whose reassurance did the lifting, slipped about 1% on the day it delivered it 3.
The rewind: one notice, five sessions
On 24 September Oracle sent a force majeure notice to Blue Owl Capital, owner of the builder Stack Infrastructure, preserving the right to defer payments if the campus is not online in 2028 as planned 5. Oracle closed down 3.5% with its credit default swaps at a record, Blue Owl fell 3.6%, and Bloom dropped as much as 7% 857. Arm−11.67% — Arm, down 11.67 percent today fell about 7% to near $305.50 on read-through alone: its architecture sits under Oracle's cloud processors, and a deferred campus defers the CPU demand meant to fill it 6.
Roughly $18 billion of construction loans on the campus were already quoted at 89 to 91 cents on the dollar 5. Bloom recovered 8.7% on 25 September after saying Oracle "remains committed" to the 2.4 gigawatts 4. On 28 September it gave that back, down 8.7% as the notice revived financing concerns and the loans were quoted below 90 cents 9.
Oracle's paperwork moved its suppliers; Oracle itself barely moved
Data
| One-day move | |
|---|---|
| Oracle, 24 Sep (close) | -3.5 |
| Arm, 24 Sep (intraday) | -7 |
| Bloom, 24 Sep (intraday) | -7 |
| Bloom, 25 Sep (close) | 8.7 |
| Oracle, 25 Sep (intraday) | -1 |
| Bloom, 28 Sep (close) | -8.7 |
| Bloom, 29 Sep (intraday) | 13 |
The pattern: the option sits with Oracle, the date with everyone else
The notice is routine for Oracle and load-bearing for everyone else. A filing bought the right to pay late; Bloom's order book, Blue Owl's buildings and the desks holding $18 billion of loans all sit on 2028 holding. The schedule rests on permits none of them controls.
New Mexico's environment department has until 23 November to rule on the air permit for the 2,462-megawatt fuel-cell microgrid, which cannot begin construction without it 10. The gas line feeding the cells has slipped from August to February 2027, and federal regulators have not yet authorized building it 10. In July the microgrid's developer told the state it stood to lose $325 million a month beginning in November 10.
The counterweight: everyone says nothing changed
Oracle calls such notices commonplace on projects of this scale, saying they "do not, by themselves, establish a project delay" 10. Stack says the companies remain "fully aligned" and the notice "does not change the financial commitments" 5. Bloom declined to answer questions about the microgrid's construction status and commissioning schedule, referring to a social media statement 10. The statements address intent. The permits decide the date.
The fork: 23 November prices 2028
If the permit lands and gas flows by early 2027, the notice stays paperwork and lenders get repaid at par. If either slips, Oracle's deferral right activates against the same counterparties that just spent five days trading on its reassurance, and $325 million a month becomes someone's income statement. The next hard reading on 2028 is a state ruling due 23 November 10.
