DTE Energy's 1-gigawatt Google deal set Michigan's data-center template; more deals by year-end

Michigan's regulator wrote the terms for hyperscale power deals in the Google case, and DTE says more agreements come by year's end. The template is now an earnings story for the utility's stock.

Vincent JiangVincent Jiangthree-minute read
Share
DTE Energy's River Rouge power plant on the Detroit River, with transmission lines at left
1 / 7Slide 1 of 7

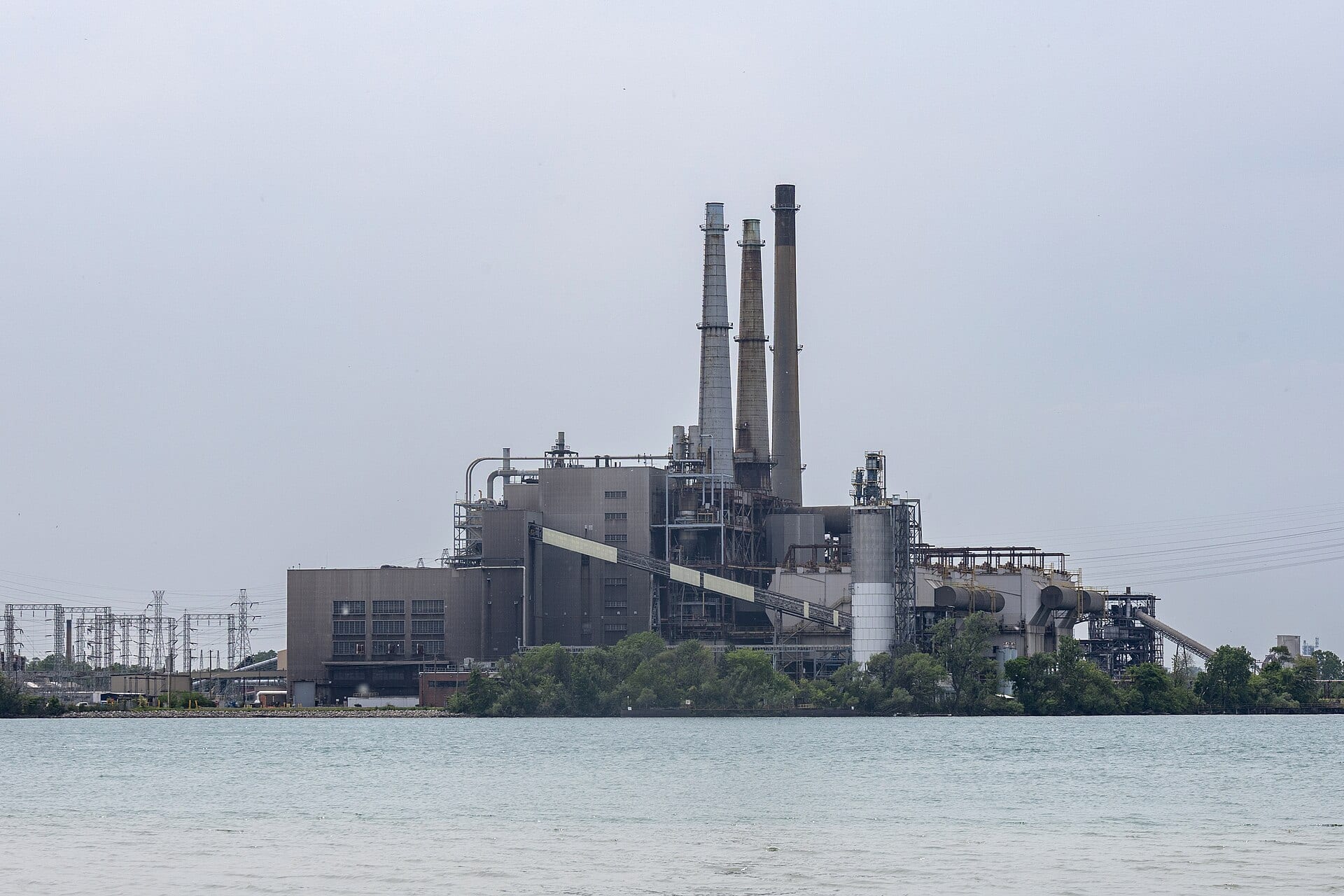

DTE Energy's River Rouge power plant on the Detroit River. The utility's hyperscale data-center contracts, including the 1-gigawatt Google deal, will pull on generation capacity like this.

Michigan just sold its template. On October 2 the Michigan Public Service Commission voted unanimously to give conditional approval to DTE Energy's contracts−0.15% — DTE Energy's contracts, down 0.15 percent today to power Google's 1-gigawatt "Project Cannoli" data center in Van Buren Township, the state's first hyperscale deal settled in a contested case 1. One day short of that vote's five-day anniversary, DTE told the market it plans to announce new data-center agreements by the end of the year 3. Every term the regulator just wrote is now the price list for the next round.

The terms the next deals must match

The primary supply agreement runs 20 years, with minimum monthly billing at 80% of contract capacity and a termination payment protecting at least 15 years of minimum charges 1. Regulators added conditions on top: the commission order commits Google to fund up to 1,600 MW of renewable generation and 480 MW of battery storage, and mlive reports the exit payment could reach $2.5 billion 12. Commission chair Dan Scripps put it plainly: "Google can pay its own energy bills" 2. The campus begins service in December 2027 and hits maximum load by December 2028 1.

The two camps, and the veto

Attorney General Dana Nessel pushed for a 90% minimum billing demand and termination math at 100% of remaining contract months, and her office called the cost-shift risks "unprecedented" 12. She lost, on paper. The Environmental Law & Policy Center said the commission held DTE accountable but failed to make Google fund distributed grid solutions 1. Off the docket, the money was settled anyway: Wayne County's commission overrode Executive Warren Evans' veto of a tax exemption saving Google more than $125 million, and Van Buren's planning commission can approve the final site plan as soon as October 14 12.

What the contract is worth to the stock

For DTE shareholders, the order converts consumer-protection language into an earnings-quality argument. CEO Joi Harris told analysts the Google project and other data-center opportunities provide upside to the plan, and analysts peg the deal's capex pull at roughly $5 billion through 2032 4. DTE already carries 2.4 GW of signed hyperscale deals, with five to six GW more in the pipeline, against a stock near its 52-week low 4. The question for the year-end announcements is arithmetic: the template is de-risked growth, the only open variable is how many gigawatts sign it.

DTE's signed data-center load, and the pipeline behind the year-end announcements

  • Estimate
0246Oracle/OpenAI, Saline Township1.4Google, Van Buren Township1DTE pipeline, additional deals5–6
Data
ValueRange
Oracle/OpenAI, Saline Township1.4—
Google, Van Buren Township1—
DTE pipeline, additional deals (estimate)5.55–6
Gigawatts of hyperscale data-center load tied to DTE contracts in Michigan. Sources: Michigan Advance, October 2, 2026; mlive, October 1, 2026; 24/7 Wall St., September 16, 2026 (pipeline is DTE management's figure, shown as estimate).1,2,4

The contrast that should worry everyone else

December's Oracle−6.58% — Oracle, down 6.58 percent today and OpenAI$1.18T — OpenAI, private, latest valuation $1.18T deal, a 1.4-GW campus in Saline Township, was waved through ex parte, without testimony or cross-examination 12. The Google case took six months of contested process to land on weaker minimums than the Attorney General wanted. The pattern points one way: each new deal inherits a precedent, and each approval makes the next scrutiny shorter. Investors reading DTE's 15-year payment protection should read the regulator's calendar too.

Get Power by email, free

How AI's hunger for electricity moves utilities, power plants and the grid. In our daily email, every weekday.

Loading DTE

Reader comments

0 comments

    Power

    An Indiana county asks American Electric Power to suspend a 75-mile line behind its $100 billion plan

    AEP's growth case, 84 gigawatts of new contracted load and $100 billion of spending through 2031, needs land, ballots and regulators to say yes. On Nov. 17 an Indiana county board asked the utility to suspend one of the transmission lines behind it, two weeks after voters restricted data centers in 40 of 41 ballot contests.

    Power

    Southern Company closed a $2 billion equity-unit sale at 8.625%, a third of it paid in stock

    Underwriters took their option in full on November 17, and only 5.50 of the 8.625 points is cash interest; the rest is paid in stock out of Southern's equity. Three days later Alabama Power handed $160 million of the same data-center revenue back to ratepayers.

    Power

    Ameren asks Missouri to bill customers for its 2,100 MW gas plant while it is built, cost still redacted

    Ameren pressed the request at a Nov. 18 hearing, with the plant's cost still redacted in its own filings. The financing ruling decides who pays during construction: Missouri bills if it is granted, Ameren's $38.1 billion plan and $5 billion of new equity if it is refused.

    Power

    Alabama Power files to cut 2027 rates by $160 million, crediting data centers

    The Southern Company utility says data centers that pay their own way will cut a typical Alabama home's bill by more than $50 a year from January. It lands while US electricity inflation runs 4.4 percent and utilities elsewhere seek $23 billion of increases.

    Power

    Iberdrola says it fixes data-center power prices for 20 years in Spain, where 88% of grid requests fail

    Spain let in 12% of grid-access requests in 2025, and Iberdrola's Spain chief says the data-center money has already applied to plug in. The 20-year fixed price he described turns AI power demand into contracted cash for Iberdrola shareholders and locks the biggest cost line in a data center's budget.

    Power

    Illinois cuts WEC's Peoples Gas rate increase 72% to $40 million as 15 banks market up to $4 billion of stock

    The order is the second regulator trim of a WEC Energy utility in two weeks. It lands while 15 banks market up to $4 billion of WEC stock for a $47.5 billion data-center build whose biggest customers pay on terms no rate case can touch.

    Subscribe to TheInference for free
