Fermi Inc. hits $3.42, a 52-week low, as an NRC draft backs four reactors its $62.5 million cannot fund

The first accelerated, applicant-written environmental review in NRC history preliminarily backs the combined license for Fermi's four-reactor, 17 GW Project Matador. The same session printed a 52-week low, with the filings pricing the build at $70 billion to $90 billion against $62.5 million of quarter-end cash.

Vincent JiangVincent Jiangthree-minute read

Drafted with AI from the documents listed under Sources, then edited and fact-checked by Vincent Jiang. How we work

Share
Aerial photograph of Plant Vogtle in Georgia, with the AP1000 construction site cleared in the foreground
1 / 6Slide 1 of 6

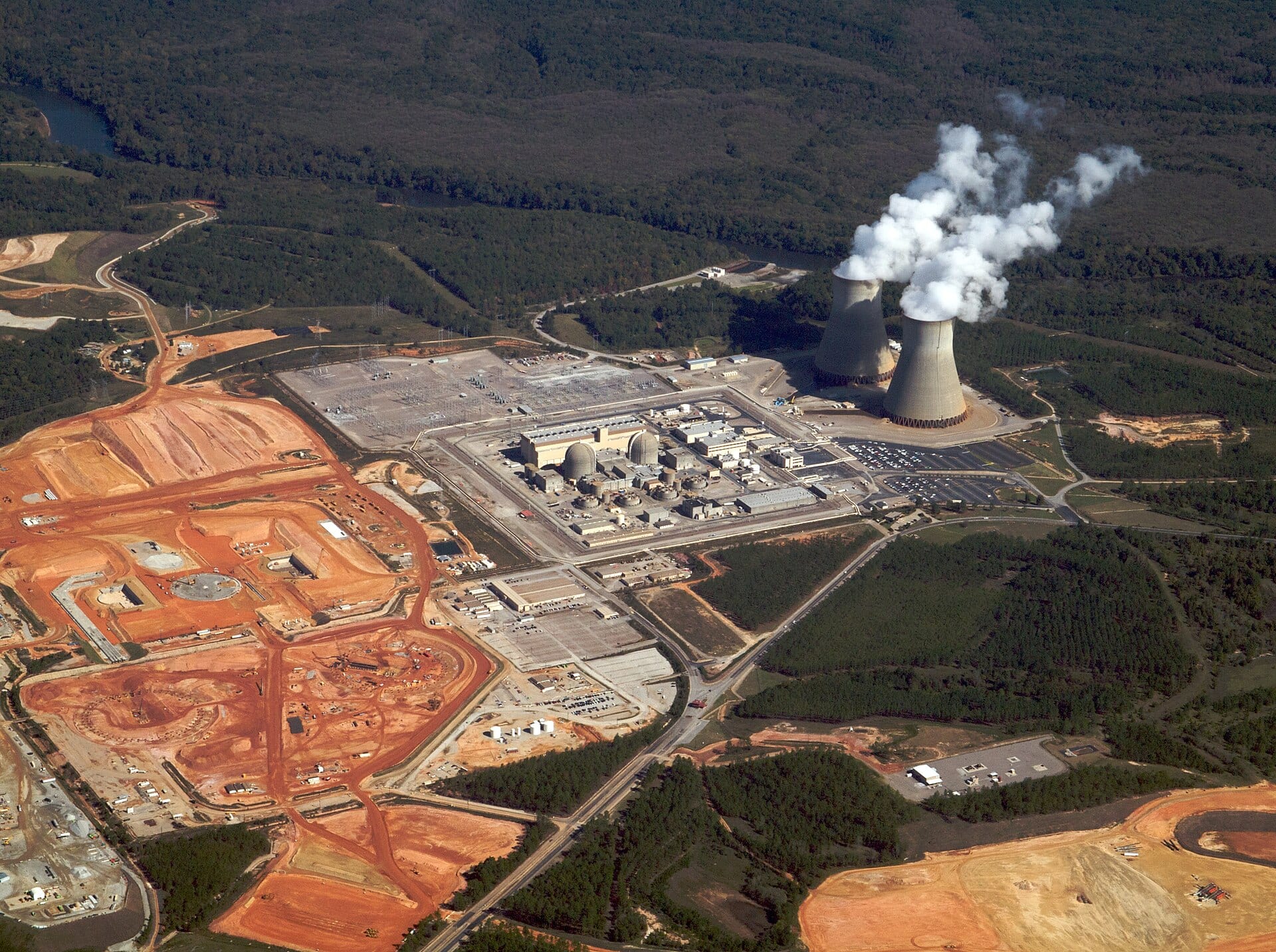

AP1000 construction at Plant Vogtle in Georgia, photographed in October 2011. Fermi's Project Matador plans four AP1000 reactors of the same design near Amarillo, Texas.

The EIS opens for comment the day the stock hits $3.42

Two verdicts on Project Matador landed in one session on October 9 12. The Nuclear Regulatory Commission published a draft environmental impact statement for Fermi's four planned AP1000 reactors and opened 45 days of public comment 1. Fermi Inc.−5.71% — Fermi Inc., down 5.71 percent today (FRMI) fell 6.28% to $3.42, a 52-week low 2, leaving a company founded in January 2025 and listed at a reported $15 billion valuation on a $682 million raise 4 worth $2.70 billion 3.

A preliminary yes for a 17 GW campus

The draft EIS carries a preliminary recommendation in favor of issuing the combined operating license, pending the safety review, for the Texas Tech University campus that has grown from 11 GW, 4.4 of them nuclear, toward 17 GW 14. It was the first draft EIS finished under an accelerated NEPA pilot in which the applicant wrote the document under NRC supervision 1. The Federal Register notice ran on October 9; comments close November 23 under docket NRC-2026-0100, and a final EIS is targeted for December 51.

The binding lease is not binding yet

Fermi's first binding customer lease, the August deal with AI cloud operator TensorWave for 222 MW with rights up to 650 MW 14, was signed on August 9 and is still not effective. Its closing slipped from September 30 to October 31 while Fermi negotiates a guaranty from an unnamed investment-grade counterparty, and the closing conditions also include project-level financing sufficient to fund construction 67. The $6.5 billion, 15-year headline is contracted revenue only if both arrive 7.

The balance sheet funds almost none of it

At its most recent quarter Fermi reported $62.54 million of cash against $576.39 million of debt and a $737.89 million trailing net loss 3. The second-quarter 10-Q still carries going-concern language and prices the full build at $70 billion to $90 billion 6. That gap is the who-pays: the money cannot come from this balance sheet, so it must come from new equity sold into a tape that has nearly halved the company since June, and the dilution lands on today's holders 36.

Fermi holds 11 cents of cash for every dollar of debt

$0M$200M$400M$600M$800MCash$62.54MTotal debt$576.39MTrailing net loss$737.89M
Data
Value
Cash$62.54M
Total debt$576.39M
Trailing net loss$737.89M
Quarter-end cash, total debt and trailing net loss for Fermi Inc., in millions of dollars, from its key statistics as collected by Yahoo Finance on October 9, 2026; the second-quarter 10-Q prices the full Project Matador build at $70 billion to $90 billion.3

Two contract tests sit inside the quarter. On November 10 the $500 million MUFG turbine facility steps quarterly principal from 5% to 10% of the $444.9 million drawn unless a 400 MW deal is signed 6. The Texas Tech ground lease demands a notice to proceed by December 31 backed by a 200 MW first tenant and phase-one financing 6. TensorWave clears the second bar and misses the first 6.

Fermi's market value has nearly halved since June 30

$0B$2B$4B$6B31 Dec 202531 Mar 202630 Jun 20269 Oct 2026$2.7BNRC opens draft EIS comments
Data
Market cap
31 Dec 2025$4.29B
31 Mar 2026$3.21B
30 Jun 2026$5.12B
9 Oct 2026$2.7B
Market value at quarter ends and on October 9, 2026, as reported by Yahoo Finance for Fermi Inc. Fermi listed in October 2025.3

Turbines are on the ground; revenue is not

The first Siemens gas turbines reached the site near Amarillo in September, and more than $1.5 billion is invested with roughly 6 GW permitted 64. Revenue starts only when finished halls are delivered to TensorWave, in phases from late 2027 into the first quarter of 2028 6.

A founder in court, a vote on October 30

A Texas business court denied every emergency request from co-founder Toby Neugebauer on September 16, holding that state law permits the bylaw amendments he challenged 8. SEC filings say Fermi terminated him for cause 1. His amended suit against three directors goes on, and shareholders vote at the October 30 annual meeting on his call for an independent review, with his stake near 22% 96.

Six dates decide the fourth quarter

Blue Energy, racing the same Texas clock, filed the first part of its construction permit for five BWRX-300s at the Port of Victoria on September 16 1. For Fermi the calendar runs: annual meeting October 30, lease close October 31, MUFG test November 10, comments close November 23, final EIS in December, Texas Tech deadline December 31 61. Management wrote that its plans alleviate the going-concern doubt 6. The NRC has answered the environmental question. Nobody has answered the financing one.

Sources

  1. 1American Nuclear Society, Nuclear News: Fermi America, Blue Energy make strides in Texas, 9 October 2026
  2. 2Investing.com: Fermi Inc stock hits 52-week low at 3.42 USD, 9 October 2026
  3. 3Yahoo Finance Australia: Fermi Inc. (H3V.DE) valuation measures and financial statistics, collected 9 October 2026
  4. 4Datacenter Dynamics: Fermi signs agreement with TensorWave for up to 650MW of data center capacity at Project Matador site, 11 August 2026
  5. 5Federal Register: NRC notice, Fermi America LLC; Project Matador AP1000 Units 1-4; Draft Environmental Impact Statement, published 9 October 2026
  6. 6FinanceFeeds: Fermi Delays $6.5B TensorWave Lease Close to Oct. 31, 23 September 2026
  7. 7FinanceFeeds: A $6.5 Billion Data Center Lease Still Has No Guarantor, and the Clock Runs to October 31, 25 September 2026
  8. 8PR Newswire via Morningstar: Texas Business Court Denies Former CEO's Request for Emergency Relief Against Fermi's Board, 17 September 2026
  9. 9Stocktwits via MSN: FRMI stock climbs overnight: Former CEO sues three directors over power grab allegations, 21 September 2026

Get Power by email, free

How AI's hunger for electricity moves utilities, power plants and the grid. In our daily email, every weekday.

Loading FRMI

Reader comments

0 comments

    Power

    Fluence Energy's filing shows backlog up 39% to a record $8.9 billion in the quarter it cut guidance twice

    The same filing shows its commitments to buy battery cells more than doubled in a year, to $2.7 billion. Shareholders have paid the higher cell prices so far, through a negative gross margin; customers pay only if the $3.5 billion of new orders were priced above what the cells will cost.

    Power

    LIPA holds up to $1.1 million of PSEG Long Island's pay to a customer bill of rights

    PSEG Long Island's president Scott Jennings accepted 10 service standards and a 12-point bill of rights on November 18, and shut-offs stay barred through April 15. For PEG holders the bonus is tiny; the hold now runs through a contract to 2030 and an open statewide review.

    Power

    Chile's power tribunal sides with Enel over Engie, ordering a count of the desert's stability needs

    The tribunal upheld Enel's demand for a quantified voltage-control requirement and rejected Engie's push to declare a deficit now. A number would become tenders and tariffs, and Enel already has grid-forming batteries rising in the desert.

    Power

    An Indiana county asks American Electric Power to suspend a 75-mile line behind its $100 billion plan

    AEP's growth case, 84 gigawatts of new contracted load and $100 billion of spending through 2031, needs land, ballots and regulators to say yes. On Nov. 17 an Indiana county board asked the utility to suspend one of the transmission lines behind it, two weeks after voters restricted data centers in 40 of 41 ballot contests.

    Power

    Southern Company closed a $2 billion equity-unit sale at 8.625%, a third of it paid in stock

    Underwriters took their option in full on November 17, and only 5.50 of the 8.625 points is cash interest; the rest is paid in stock out of Southern's equity. Three days later Alabama Power handed $160 million of the same data-center revenue back to ratepayers.

    Power

    Ameren asks Missouri to bill customers for its 2,100 MW gas plant while it is built, cost still redacted

    Ameren pressed the request at a Nov. 18 hearing, with the plant's cost still redacted in its own filings. The financing ruling decides who pays during construction: Missouri bills if it is granted, Ameren's $38.1 billion plan and $5 billion of new equity if it is refused.

    Subscribe to TheInference for free
