Power

Washington lends Vistra $4.2 billion for reactor upgrades it won't ask the NRC to approve until 2029

Energy Secretary Chris Wright announces about $4.2 billion of federal financing today for nuclear uprates at three PJM plants. Construction starts this month; the NRC's schedule puts Vistra's Perry application in the third quarter of 2029, and Meta already bought the megawatts.

Vincent JiangVincent Jiangtwo-minute read
Share
Energy Secretary Chris Wright in his official Department of Energy portrait

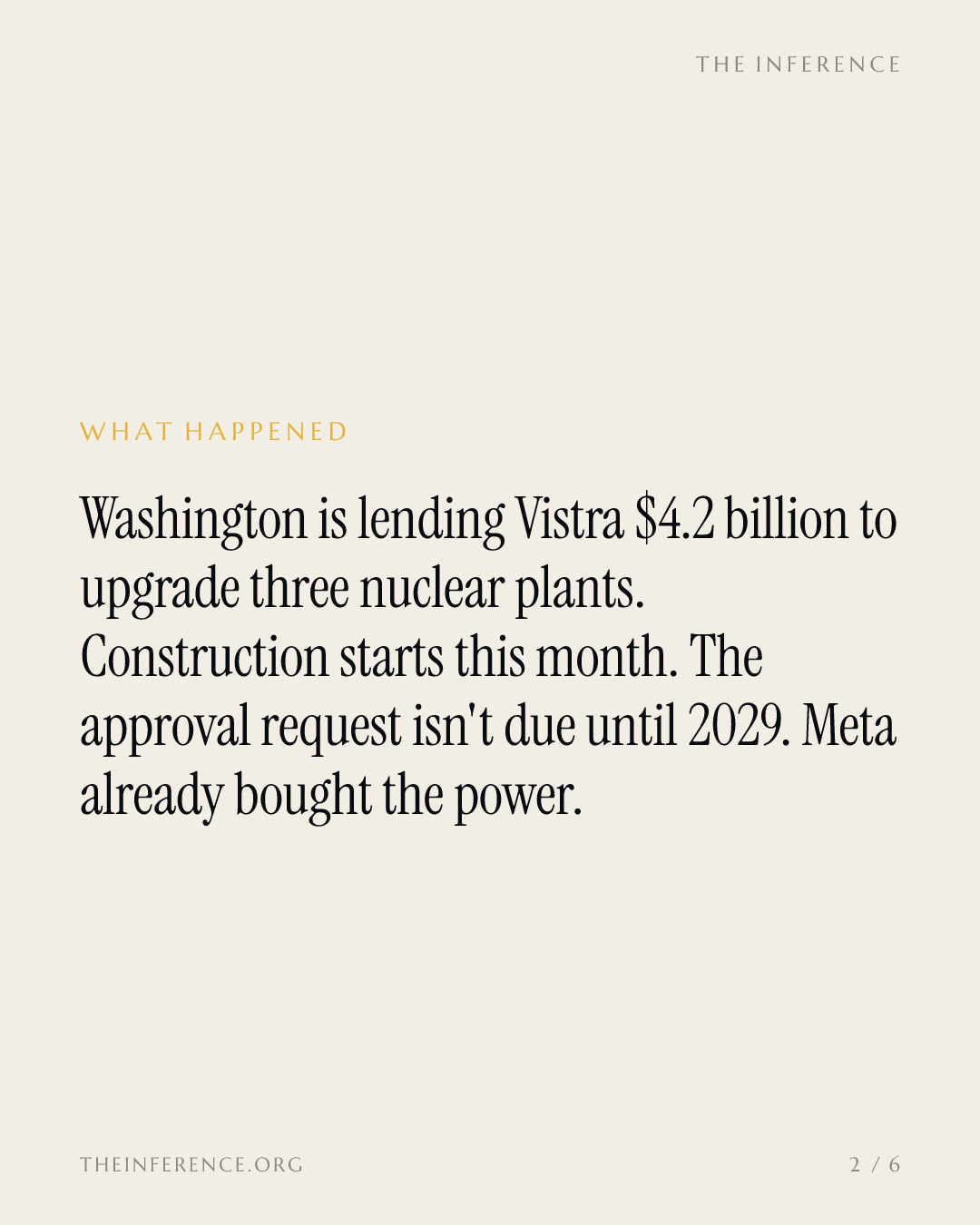

1 / 6Slide 1 of 6
Energy Secretary Chris Wright, who announced about $4.2 billion of federal loans for Vistra's nuclear uprates at the Perry plant today.

The check arrives at Perry before the license does

Energy Secretary Chris Wright is at Vistra's+7.59% — Vistra, up 7.59 percent today Perry plant on Lake Erie today to announce about $4.2 billion in federal loans for uprates at Perry, Davis-Besse and Beaver Valley, three of Vistra's four nuclear stations 12. The stock jumped 6.2% to $148.70 in premarket trade 5. The amount is a person-familiar figure; DOE and Vistra had not confirmed it as of Saturday 1.

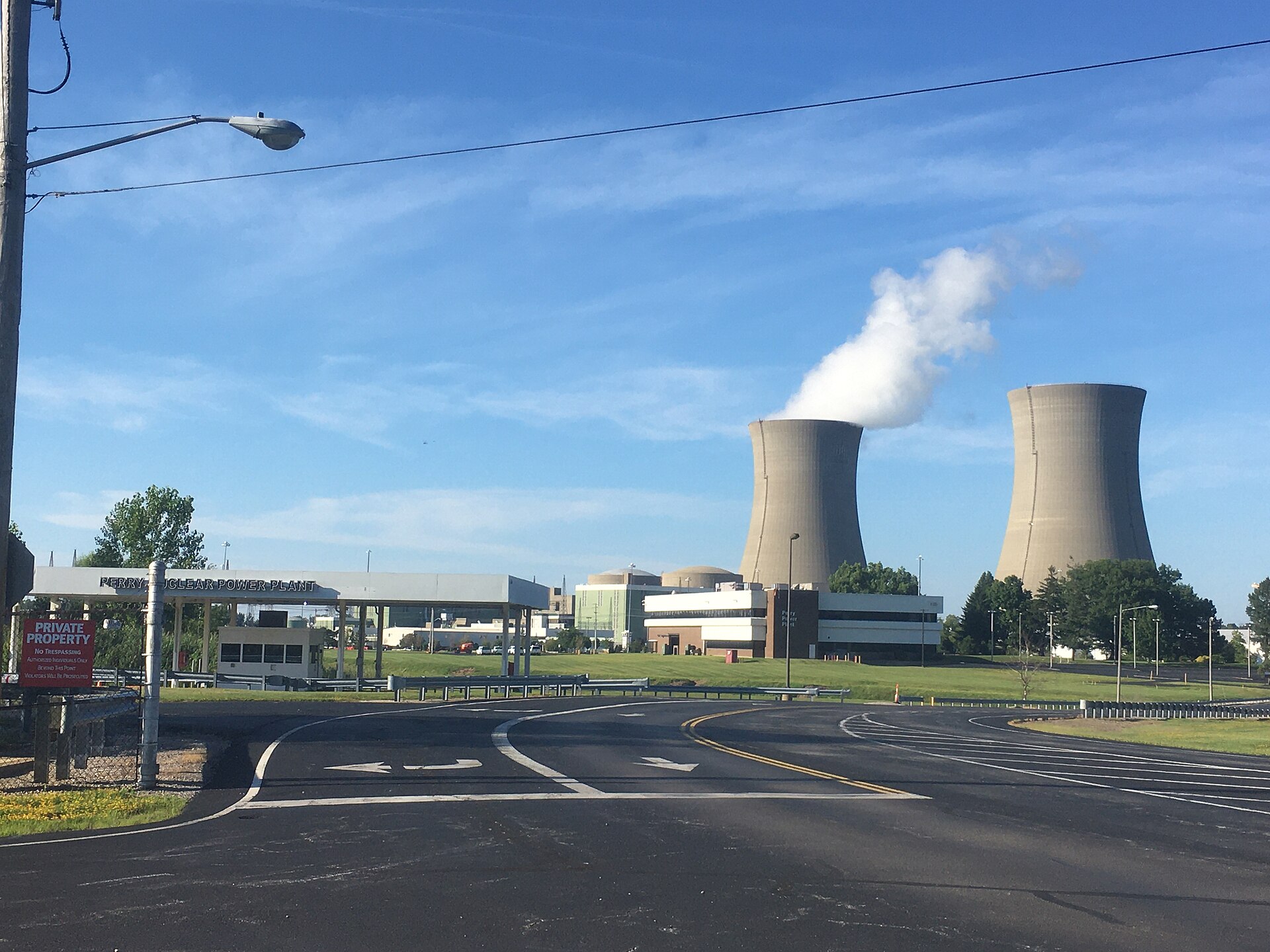

Entrance road and cooling towers of the Perry Nuclear Power Plant on Lake Erie
The Perry Nuclear Power Plant on Lake Erie. Its 200 MW uprate enters construction this month under DOE's filing, nearly three years before the NRC expects Vistra's application.Cards84664 (CC BY-SA 4.0)

Federal cash moves at data-center speed, licensing does not

A DOE filing dated September 15 puts Perry's uprate construction at October 2026, now, with a loan guarantee under review in the Office of Energy Dominance Financing 2. The NRC's published schedule lists Vistra's expected application for Perry's extended power uprate in the third quarter of 2029 2, and the agency allows a reactor to run above its licensed power only after it approves 4. Federal money moves at data-center speed; nuclear licensing does not.

Meta already bought the answer

Vistra fixed the economics in January: 20-year agreements with Meta for 2,609 MW across the three plants, including 433 MW of uprate capacity, the largest uprates backed by a corporate customer in the country, fully online by 2034 3. Perry's 200 MW arrives in 2031 2, and Vistra says the investments meet or exceed its mid-teens levered return target 2. Set against the 6,831 MW shortfall PJM has flagged for the 2028/29 delivery year 26, the program is a dent, and PJM's own fix, a 6.8 GW backstop procurement, was partly rejected at FERC on September 29, delaying the auction that was to open this week 6.

The $4.2 billion buys 433 MW against a 6,831 MW hole

0 MW2,000 MW4,000 MW6,000 MW8,000 MWPJM 2028/29 shortfall6,831 MWVistra uprates sold to Meta433 MWPerry addition (DOE filing)200 MW
Data
Value
PJM 2028/29 shortfall6,831 MW
Vistra uprates sold to Meta433 MW
Perry addition (DOE filing)200 MW
Megawatts. The shortfall is PJM's identified gap for the 2028/29 delivery year; uprate capacity is what Vistra contracted to Meta in its January 2026 PPAs; Perry's expected addition is per DOE's September 2026 filing as reported. Sources: Construction Review; Vistra release; Utility Dive.2,3,6

Talen cashed the same scarcity out

Talen+10.24% — Talen, up 10.24 percent today, the other nuclear fleet in PJM pressing data-center demand, monetized about $1.5 billion of cleared PJM capacity revenues for the 2027/28 and 2028/29 delivery years at SOFR plus 200 basis points with Citi, and spent it on a $1.5 billion accelerated buyback 7. Vistra borrowed the federal balance sheet to build instead 1, after quietly extending its own commodity-linked revolver to September 2027 under a Citibank-led amendment 8.

The terms are unpublished; the dates are not

The loan's rate, recourse and conditions are unpublished 12. The answers land on a calendar: the NRC window in the third quarter of 2029, refueling-outage work in 2027, 2029 and 2031 2, and Talen's buyback closing by the first quarter of 2027 7.

Money lands in 2026; the license is expected in 2029, Perry's megawatts in 2031, Meta's full 2,609 MW by 2034

  • from
  • to
05001,0001,5002,0002,500NRC sees Perry's application2,0262,029+0.1%Perry's 200 MW uprate online2,0262,031+0.2%Meta's 2,609 MW fully online2,0262,034+0.4%
Data
fromtoChange
NRC sees Perry's application2,0262,029+0.1%
Perry's 200 MW uprate online2,0262,031+0.2%
Meta's 2,609 MW fully online2,0262,034+0.4%
Years. Each bar runs from October 2026, when uprate construction starts under DOE's filing, to the milestone: the NRC's published schedule expects Perry's extended power uprate application in the third quarter of 2029, Perry's 200 MW arrives in 2031, and the Meta agreements are fully online by 2034. Sources: Construction Review; Vistra release; NRC.2,3,4

Get Power by email, free

How AI's hunger for electricity moves utilities, power plants and the grid. In our daily email, every weekday.

Loading VST

Reader comments

0 comments

    Power

    LIPA holds up to $1.1 million of PSEG Long Island's pay to a customer bill of rights

    PSEG Long Island's president Scott Jennings accepted 10 service standards and a 12-point bill of rights on November 18, and shut-offs stay barred through April 15. For PEG holders the bonus is tiny; the hold now runs through a contract to 2030 and an open statewide review.

    Power

    Chile's power tribunal sides with Enel over Engie, ordering a count of the desert's stability needs

    The tribunal upheld Enel's demand for a quantified voltage-control requirement and rejected Engie's push to declare a deficit now. A number would become tenders and tariffs, and Enel already has grid-forming batteries rising in the desert.

    Power

    An Indiana county asks American Electric Power to suspend a 75-mile line behind its $100 billion plan

    AEP's growth case, 84 gigawatts of new contracted load and $100 billion of spending through 2031, needs land, ballots and regulators to say yes. On Nov. 17 an Indiana county board asked the utility to suspend one of the transmission lines behind it, two weeks after voters restricted data centers in 40 of 41 ballot contests.

    Power

    Southern Company closed a $2 billion equity-unit sale at 8.625%, a third of it paid in stock

    Underwriters took their option in full on November 17, and only 5.50 of the 8.625 points is cash interest; the rest is paid in stock out of Southern's equity. Three days later Alabama Power handed $160 million of the same data-center revenue back to ratepayers.

    Power

    Ameren asks Missouri to bill customers for its 2,100 MW gas plant while it is built, cost still redacted

    Ameren pressed the request at a Nov. 18 hearing, with the plant's cost still redacted in its own filings. The financing ruling decides who pays during construction: Missouri bills if it is granted, Ameren's $38.1 billion plan and $5 billion of new equity if it is refused.

    Power

    Alabama Power files to cut 2027 rates by $160 million, crediting data centers

    The Southern Company utility says data centers that pay their own way will cut a typical Alabama home's bill by more than $50 a year from January. It lands while US electricity inflation runs 4.4 percent and utilities elsewhere seek $23 billion of increases.

    Subscribe to TheInference for free
