Trane buys its own coil supplier the day Nvidia promises near-zero-water AI factories

Trane Technologies agreed on October 21 to buy Cancoil Thermal, the family firm that already supplies its heat-rejection coils, the same day Nvidia showcased an AI-factory blueprint it says needs almost no water. Both announcements value the same layer: the hardware that carries heat out of the building.

Vincent JiangVincent Jiangthree-minute read
Share
Donny Simmons, chief operating officer of Trane Technologies
1 / 6Slide 1 of 6
Trane Technologies chief operating officer Donny Simmons called Cancoil "a critical capability at the right time."

A family firm sells to its own customer

On October 21, Trane Technologies+2.57% — Trane Technologies, up 2.57 percent today (NYSE: TT) agreed to buy Cancoil Thermal, the Ontario, Canada manufacturer that already supplies coils and coolers to its chiller and air-handling businesses 12. Cancoil was founded in 1983 by Chander and Anju Datta and employs more than 450 people at plants in Ontario and Jacksonville, Texas 1. Terms were not disclosed; the deal is expected to close before the end of the year, subject to regulatory approval, with investment bank Lazard advising Cancoil 123.

Chief Operating Officer Donny Simmons called Cancoil "a critical capability at the right time," and the announcement lists data centers first among its end markets 1. The stock closed up 2.17% at about $471.42 3.

Nvidia's blueprint still ends at a dry cooler

The same day at GTC Berlin, Nvidia's+3.65% — Nvidia, up 3.65 percent today conference, the chipmaker said European partners are building AI factories on DSX, its reference design that treats chips, power and cooling as one system, and it named Trane among the participating engineering firms 4.

The near-zero-water claim is a hardware claim: coolant runs past the chips in a closed loop and releases its heat to the outdoor air through dry coolers, with no water evaporated 45. Nvidia says a two-gigawatt site built that way saves 54 million litres a day 4, the daily water use of 180,000 households 5.

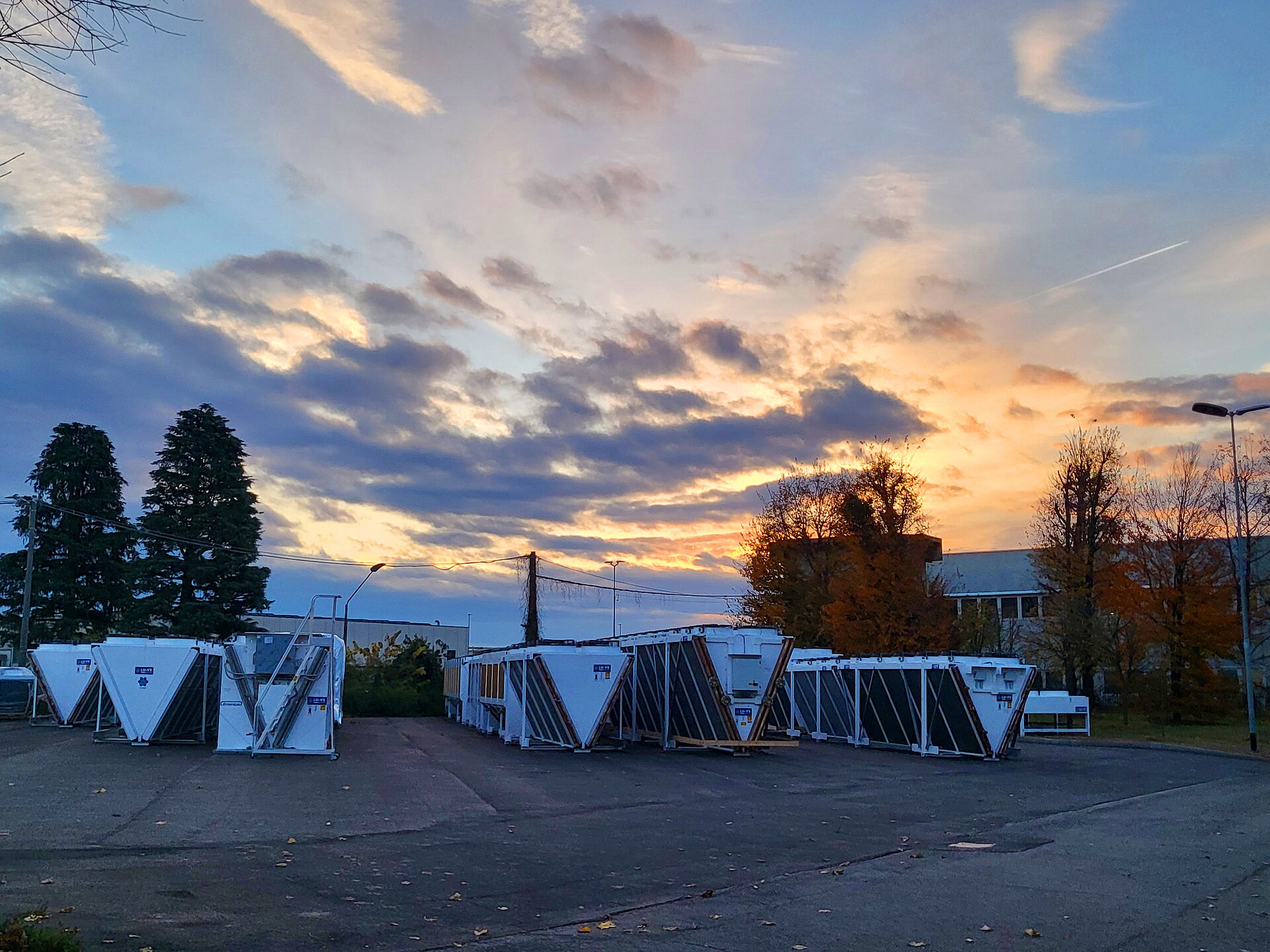

Rows of V-shaped dry coolers standing in a manufacturer's yard at sunset
Dry coolers built by Italy's LU-VE: hardware that rejects heat to outdoor air with no water evaporated, the layer at the center of both announcements.Nico aspe 22 via Wikimedia Commons

Trane has already published seven thermal reference designs, three of them 250-megawatt DSX blueprints; one pairs modular cooling plants from Stellar Energy, bought alongside liquid-cooling maker LiquidStack, with dry fluid coolers stacked on top 56. Cancoil's fluid coolers and coils are that layer.

The prices nobody disclosed

The Nvidia camp wants to compress the build itself: DSX POD, a factory-built container design, cuts deployment at a prepared site from six months to as little as 14 days, with Dell, Schneider Electric and Vertiv+4.01% — Vertiv, up 4.01 percent today delivering in early 2027 7. Inside the same program, Vertiv's 2.3-megawatt CoolChip coolant unit is DSX Ready beside Trane's GigaModular, rivals listed side by side 5.

Demand shows in the books, the bill does not

Demand shows in Trane's books: second-quarter revenue hit $6.4 billion, up 10.6% in a year, and backlog reached a record $12.1 billion, up 70%, mainly on data-center chillers 89. Trane locks in coil supply against that backlog, the Datta family sells a 40-year-old firm to its own customer, and independent coil makers now face a market consolidating around the incumbents they supply 1268. What no document carries is the bill: Trane never disclosed what it paid for Cancoil 12, and the prices of LiquidStack and Stellar appear nowhere in the coverage here 68.

Trane's quarterly revenue hit a record $6.4B in Q2 2026

$0B$2B$4B$6B$8BQ4 '23Q2 '24Q4 '24Q2 '25Q4 '25Q2 '26Backlog hit a record $12.1B, up70% in a year
Data
Revenue
Q3 '23$4.88B
Q4 '23$4.42B
Q1 '24$4.22B
Q2 '24$5.31B
Q3 '24$5.44B
Q4 '24$4.87B
Q1 '25$4.69B
Q2 '25$5.75B
Q3 '25$5.74B
Q4 '25$5.15B
Q1 '26$4.97B
Q2 '26$6.35B
Quarterly revenue, USD billions, from Trane Technologies' SEC filings; Q2 2026 ended June 30, 2026. Backlog note from The Motley Fool, August 20, 2026.8,9

Trane reports third-quarter results on October 29 6; the Cancoil deal is expected to close by year-end 23. Nvidia can standardize the chip side of cooling; the heat still has to leave the building through somebody's coils.

Get Data Center by email, free

Who is building AI's data centers, and who is paying for them. In our daily email, every weekday.

Loading NVDA

More about NVIDIA

NVDAFiscal Q2 2027
Fiscal Q2 2027 · quarter to 26 Jul 2026 · changes vs a year earlier

Revenue rose 106% to $96.2B, 92.5% of it from Data Center, “driven by the ramp of our Blackwell Ultra infrastructure”. Gains on equity stakes of $7.8B lifted net income to $59.7B.

Revenue$96.2B▲ 106%
Gross margin75.0%▲ 2.6 pts
Operating margin66.2%▲ 5.4 pts
Net income$59.7B▲ 126%
Hyperscale$48.7B▲ 102%AI clouds & enterprise$40.3B▲ 138%Data Center$89.0B▲ 117%Edge Computing$7.2B▲ 27%Revenue$96.2B▲ 106%Gross profit$72.1B75.0% marginCost of revenue$24.1BOther income$7.8Bequity-stake gainsOperating income$63.7B66.2% marginOperating expenses$8.4BNet income$59.7B▲ 126%Tax$11.8B16.5% rateR&D$7.1BSG&A$1.4B
Show as a table
LineValue
Revenue$96.2B
Gross margin75.0%
Operating margin66.2%
Net income$59.7B
Hyperscale$48.7B
AI clouds & enterprise$40.3B
Data Center$89.0B
Edge Computing$7.2B
Gross profit$72.1B
Cost of revenue$24.1B
Other income$7.8B
Operating income$63.7B
Operating expenses$8.4B
Tax$11.8B
R&D$7.1B
SG&A$1.4B

Reader comments

0 comments

    More in Data Center

    All in this topic →

    Data Center

    NetApp counts 350 AI deals instead of reporting AI revenue, and insiders sold 33 times without buying

    NetApp closed its Peak:AIO purchase with no price disclosed, in the same week the books closed on a period of insider selling: 33 sales in six months, not one purchase. The stock's premium rests on an AI business the company has never reported as a revenue line.

    Data Center

    Microsoft can wait out data-center protests; its landlord Pure Data Centres cannot, with $1 billion at stake

    Activists broke into Microsoft's Amsterdam data-center site at the start of a 16-country protest weekend. The exposure is not Microsoft's; it belongs to the developers and miners paying interest before revenue, and Texas just moved against them.

    Data Center

    Texas Governor-elect Gina Hinojosa wants a SpaceX pause as Goldman syndicates $40 billion of chip debt

    Goldman and Apollo are syndicating $40 billion of SpaceX chip debt secured against a Texas buildout that the state's new governor-elect wants paused. Lenders bought pre-election terms into a post-election state.

    Data Center

    Fermi's ousted CEO sold $13 million of stock into a 52-week low, then said it 'should be soaring'

    Toby Neugebauer, ousted as Fermi's chief executive in April, sold 7,657,800 shares for about $13 million in three sessions, 5 million of them on the day the stock touched its 52-week low. The next morning he demanded the company be sold, with its only tenant lease unsigned and $62.5 million of cash against a $737.9 million trailing loss.

    Data Center

    Data-center orders tripled at Carrier, and the cost of rolling its debt doubled

    On November 4 Carrier sold $1.5 billion of notes at more than double the coupon of the paper they retire, between record data-center orders and a $3.1 billion European write-down. The coupon is the market's new price for financing the AI buildout's supply chain.

    Data Center

    Oracle's $165 billion New Mexico campus permit slipped past December 7 as lenders sell the debt

    Oracle's $664 billion backlog assumes its biggest Stargate campus switches on. The New Mexico air-permit decision just slipped past December 7, the project's lenders are heading for the exits, and the stock's 8% drop was blamed on politics instead.
