Nebius reports November 12. Its $3.5 billion Citi loan comes due October 2027.

The Amsterdam AI cloud, up 103% in 2026, dropped 6 to 7 percent this week after Microsoft said third-party GPU capacity is arriving late. Its November 12 report now has to show customer prepayments outrunning a $3.5 billion loan due October 2027.

Vincent JiangVincent Jiang · 3 min read
Share
Arkady Volozh, chief executive of Nebius Group
1 / 7Slide 1 of 7
Arkady Volozh, Nebius's chief executive, warned on Monday that certain asset-backed funding sources had been temporarily shut.

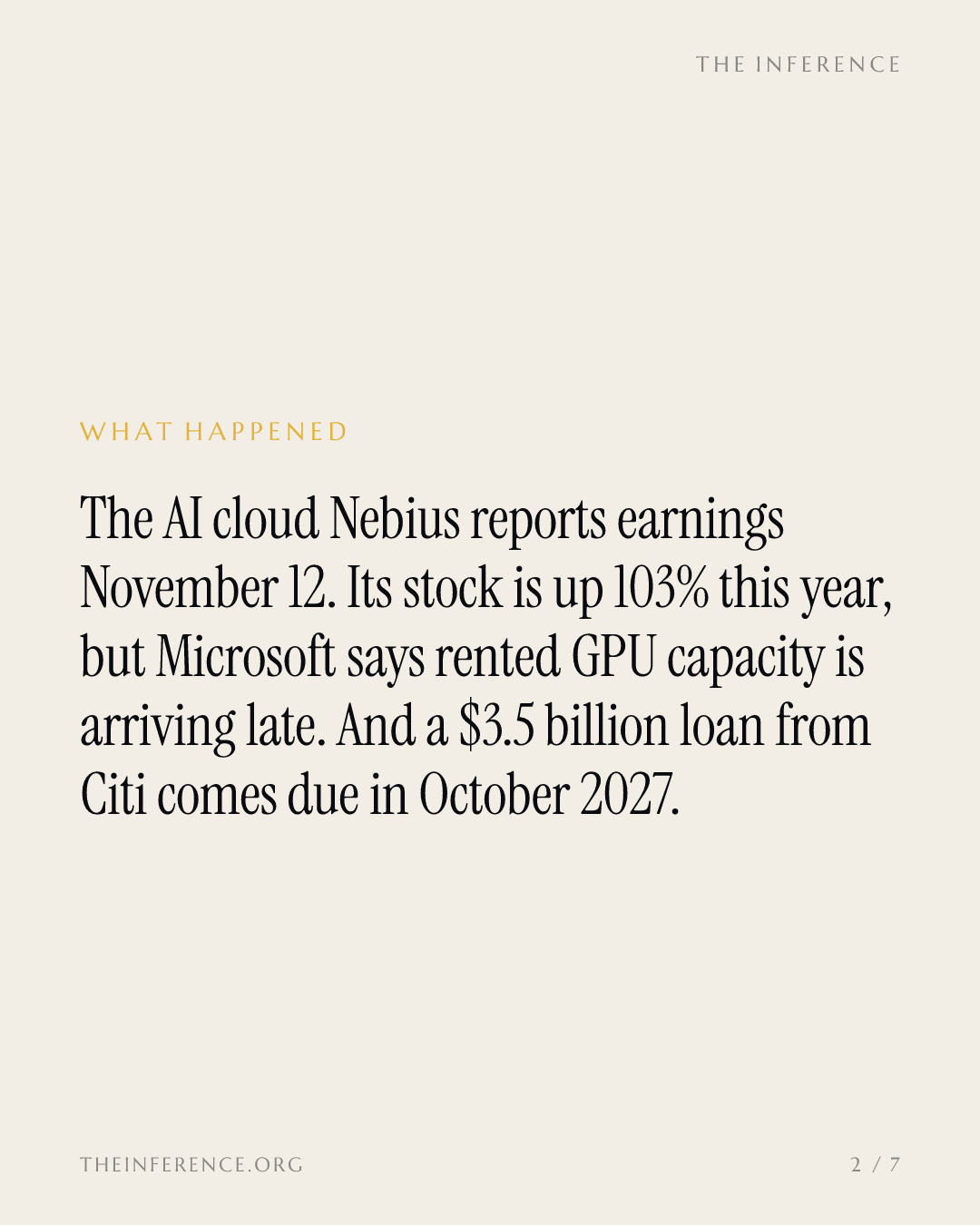

Early today Nebius−11.53% — Nebius, down 11.53 percent today Group, the Amsterdam-headquartered AI cloud listed on Nasdaq, fixed its third-quarter report for Thursday, November 12, before market open 1. The date matters more than the ritual. The stock is up 103% in 2026 through Wednesday's close 2, but it fell about 6% in Thursday's pre-market 3 and 7.4% in a single session this week 6, and the print is the first hard read on whether customers are still paying up front for a buildout the company is partly funding on a one-year loan 2.

The buyer just said later

Microsoft−1.66% — Microsoft, down 1.66 percent today, Nebius's largest customer under a contract worth $17.4 billion to $19.4 billion 2, spent $45.2 billion on capital expenditures and finance leases last quarter, about 30% more than a year earlier but short of the $50.7 billion analysts expected 4.

Finance chief Amy Hood told analysts that "some third-party capacity deliveries we expected in Q1 were delayed," and said the delays "have to do with GPU-as-a-service providers" 4, the category Nebius sells into. The money is not going away: Microsoft guided to more than $50 billion of capex in its current quarter and about $170 billion for calendar 2027 4. But the largest tenant of rented GPU capacity has told the market its third-party machines are arriving late.

The lender's clock is shorter

On October 22 Nebius agreed a $3.5 billion senior secured facility with Citi−3.16% — Citi, down 3.16 percent today: 364 days, maturing October 16, 2027, priced at SOFR plus 2.75% with the margin stepping up every 90 days to as much as 3.5%, secured by substantially all assets of the parent and two subsidiaries 56. Chief operating officer Ophir Nave called it near-term construction capital, with longer-dated financing to follow 5.

Then the mood turned. Elon Musk said debt markets had "almost entirely shut off access to money" for neoclouds without revenue outside data centers, predicting "guppy-level death" among more than 200 providers 23. And on Monday chief executive Arkady Volozh said certain asset-backed funding sources and access to debt markets had been temporarily shut 6. Piper Sandler cut its price target to $185 from $237 while keeping a Neutral rating on October 21 6.

The gap the loan has to bridge

The filings show it plainly. From March 2025 to June 2026, Nebius's quarterly debt rose from $0.19 billion to $10.06 billion and quarterly capex from $0.54 billion to $5.65 billion, against quarterly revenue that reached $582 million 7. Analysts expect about $906 million of revenue for Q3, and the number that matters most is deferred revenue, the prepayments customers hand over before capacity runs: $6.0 billion at June 30, up from $1.6 billion at the end of 2025 2.

Prepayments are the bull case

Nebius's debt and capex have outrun its revenue, six quarters running

  • Debt
  • Capex
  • Revenue
0B5B10B15BQ1 '25Q2 '25Q3 '25Q4 '25Q1 '26Q2 '2610.06B5.65B0.58B
Data
DebtCapexRevenue
Q1 '250.19B0.54B0.05B
Q2 '251.19B0.51B0.11B
Q3 '254.51B0.96B0.15B
Q4 '254.89B2.06B0.23B
Q1 '269.5B2.47B0.4B
Q2 '2610.06B5.65B0.58B
Quarterly figures from Nebius's SEC filings, in US dollar billions: total debt, capital expenditures and revenue, from the quarter ended March 2025 to the quarter ended June 2026.7

If that keeps growing, prepayments and the $40 billion of investment-grade contracts can plausibly carry the buildout to refinancing; if it flattens, the company enters the year the Citi loan comes due needing more stock or more debt 25. The counterargument is real: Hood still says demand exceeds supply 4, analysts have trimmed 2027-2030 estimates by less than 2% since September 30 2, and Nebius's net debt of about $0.5 billion at June 30 was a rounding error next to CoreWeave's−11.15% — CoreWeave, down 11.15 percent today $29.5 billion on the same basis 2. The borrowing against Microsoft and Meta was already on the record 8; what is new since October 22 is the loan's short clock and, since October 28, the buyer's own delay notice. A buyer taking delivery later and a lender wanting its money back sooner are two clocks running on the same machine.

What November 12 has to show

Watch deferred revenue first, connected power second: management targets 800 MW to 1 GW connected by year-end and $7 billion to $9 billion of annualized revenue by December 52. If the print shows both, the facility is construction capital. If not, it is a deadline.

Get Data Center by email, free

Who is building AI's data centers, and who is paying for them. In our daily email, every weekday.

Loading NBIS

Reader comments

0 comments

    More in Data Center

    All in this topic →

    Data Center

    Furukawa Bets 100 Billion Yen on Fiber While Corning's Customers Lock Supply Through 2032

    TrendForce counts a 180 million fiber-kilometer global shortfall for 2026 and data-center fiber prices above five times their 2025 levels. Furukawa Electric's 100 billion yen four-country expansion answers it, but the new lines ship from late fiscal 2028, after Corning's customers have already locked supply through 2032.

    Data Center

    Hut 8 shareholders carry River Bend's interest and tax bill until the first hall opens in 2027

    The Louisiana campus's tax terms went public this week: a $7 billion Google-backstopped lease funds the build, while note interest and a smaller tax break than Meta received sit on Hut 8 shareholders until the first hall delivers in mid-2027.

    Data Center

    Fermi's $6.5 billion lease comes due Friday, and the only news this week was a rerun

    The TensorWave lease closes, extends or dies on October 31. One day out there is no closing, no financing, and the one company story circulating this week was a year-old gas press release.

    Data Center

    A short seller says Iron Mountain's data center bet barely covers its interest bill. The stock rose.

    JCapital Research shorted Iron Mountain on October 28, arguing 81% of capex buys 13% of revenue at 1.7x interest cover. The filings agree with the arithmetic; the stock rose anyway.

    Data Center

    CoreWeave's stock has halved since Core Scientific shareholders refused its $9 billion bid

    A year after voting down the $9 billion all-stock sale, Core Scientific's holders hold a refused bid worth about $7.90 a share against a $14.42 stock. The standalone bet's first public test arrives on November 5.

    Data Center

    Arista's $235 billion moat meets its most credible imitator five days before its earnings

    Apstra founder Mansour Karam's Aria Networks surfaced in Berlin with $125 million and ex-Cisco networking chief Jonathan Davidson on its board, claiming a $300 billion prize. The software-led playbook Arista rode to $235 billion is being run back at it, and the November 3 earnings print is the first market test of what the challenger is worth.

    Get the newsletter

    The day's AI and market news, in your inbox every weekday.
