CoreWeave's funding gap: Goldman Sachs says $23 billion, Bernstein says $76 billion, bonds yield 16%

Goldman Sachs says CoreWeave needs about $23 billion more to fund its backlog; Bernstein says $76 billion. The bond market is already trading the bigger number.

Vincent JiangVincent Jiangthree-minute read
Share
Michael Intrator, co-founder and chief executive of CoreWeave, speaking at the Senate Commerce Committee's AI hearing
1 / 6Slide 1 of 6
CoreWeave chief executive Michael Intrator at the Senate Commerce Committee's "Winning the AI Race" hearing in Washington, 8 May 2025.

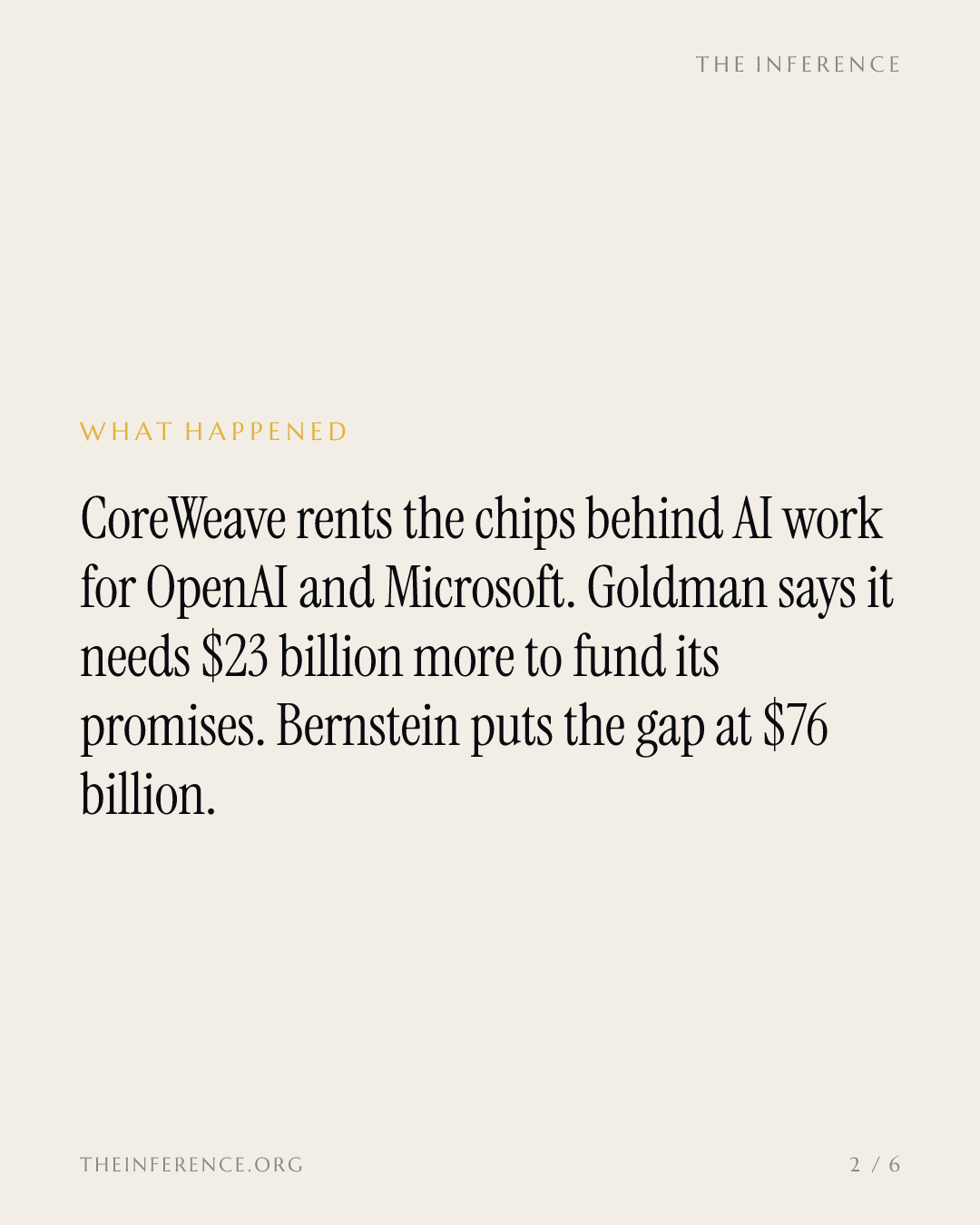

Goldman Sachs−2.68% — Goldman Sachs, down 2.68 percent today upgraded CoreWeave−6.61% — CoreWeave, down 6.61 percent today (NASDAQ: CRWV), the largest "neocloud" renting GPU capacity to AI labs including OpenAI$1.18T — OpenAI, private, latest valuation $1.18T and Microsoft−0.74% — Microsoft, down 0.74 percent today, to Buy on October 19 with a $106 target, and sized its remaining funding need at about $23 billion 1. HSBC cut the stock to Reduce at $39 the next day 2. On October 22, Bernstein analyst Madison Rezaei did the sum from the other end: about $85 billion to fund the committed backlog, minus $9 billion of financing already in place, leaves roughly $76 billion still to raise 31.

What the filings admit

The backlog stood near $104 billion in June 3. Second-quarter revenue was $2.575 billion 1. Interest expense jumped from $267 million to $640 million in the quarter, on a $626 million net loss 3. Debt hit $51.6 billion at the end of June, up from $10.6 billion at the end of 2024, and capital spending has topped operating cash flow in all eight quarters since late 2024 6.

Capex has outrun operating cash in all eight quarters

  • Capital expenditure
  • Operating cash flow
-$2B$0B$2B$4B$6B$8BQ3 '24Q4 '24Q1 '25Q2 '25Q3 '25Q4 '25Q1 '26Q2 '26$6.42B
Data
Capital expenditureOperating cash flow
Q3 '24$1.22B$0.64B
Q4 '24$3.5B$0.19B
Q1 '25$1.41B$0.06B
Q2 '25$2.45B-$0.25B
Q3 '25$2.39B$1.69B
Q4 '25$4.06B$1.56B
Q1 '26$7.7B$2.98B
Q2 '26$6.42B$0.68B
Quarterly, USD billions, from CoreWeave's SEC filings, Q3 2024 through Q2 2026.6

Two camps, one balance sheet

HSBC's Abhishek Shukla, whose bank sees 2028 to 2030 earnings 50 to 70% below consensus, puts average 2026 to 2030 returns on invested capital at 8.9%, below the cost of borrowing: "The more the company invests with this return profile, the more the value destruction" 21. Goldman's reply: "Not all neoclouds are created equal," citing GPU-backed loans and investment-grade customers such as Microsoft and Meta−2.63% — Meta, down 2.63 percent today 4. Chief executive Michael Intrator told staff the selloff was overdone, listing the levers as infrastructure borrowing, corporate debt, equity and customer prepayments 4.

The bond market had already voted

Goldman's upgrade lasted less than one session 1. The shares closed October 22 at $55.60, down 10% on the day and 36% this month 4. The 2031 and 2032 notes yield 15 to 16% 5, and the long-term debt rate passed 16% last week, far past the 8% line where junk territory starts 7.

The cost of insuring the debt against default hit a record 1,194.5 basis points on October 14 and 15 5. High-yield desks are pausing new deals until after the midterm elections 4, and rival Nebius just borrowed $3.5 billion twelve points cheaper, as The Inference reported. Thirty-two of 45 analysts still rate the stock a Buy 2.

Three targets, $67 apart, on a stock that closed at $55.60

$0$50$100$150Goldman Sachs, Buy (19 Oct)$106Bernstein, Underperform (22 Oct)$51HSBC, Reduce (20 Oct)$39Close on October 22: $55.60
Data
Value
Goldman Sachs, Buy (19 Oct)$106
Bernstein, Underperform (22 Oct)$51
HSBC, Reduce (20 Oct)$39
Analyst price targets issued October 19 to 22, 2026, against the October 22 closing price.1,2,4

What settles it

Third-quarter results land next month, consensus expects negative free cash flow of $10.1 billion in the quarter, and Baird's Rob Oliver forecasts about $30 billion of fresh capital needed in 2027 4. The tell is mechanical: the yield on the 2032 notes and the next financing announcement 145. A fall says Goldman was right and the fear was the trade; a rise says the $76 billion hole is real 1. Nvidia−4.19% — Nvidia, down 4.19 percent today, holding about 9% and backstopping unsold capacity through April 2032, is the rescuer nobody has called 45.

Get Data Center by email, free

Who is building AI's data centers, and who is paying for them. In our daily email, every weekday.

Loading CRWV

Reader comments

0 comments

    More in Data Center

    All in this topic →

    Data Center

    Trane Technologies' $12.5 billion backlog waits on suppliers; CEO sees margin relief in six to nine months

    At the Baird conference on November 12, Dave Regnery put the constraint on Trane's $12.5 billion backlog in its suppliers' plants rather than its own, with relief expected in six to nine months. With detailed 2027 guidance deferred to fourth-quarter results, that timeline is the only forward margin guide investors hold.

    Data Center

    Legrand puts data centers at 32% of revenue just as Thailand asks 49 data-center builds to pause

    The French group's Southeast Asia chief put numbers on its AI exposure: data centers are about a third of revenue and close to €3 billion a year, just as Thailand and Singapore start rationing the power and water new builds need.

    Data Center

    MARA sold 13,597 bitcoin for $1.1 billion, cut debt 37%; two AI leases by Dec. 31 decide the stock

    Traders blamed the miner for bitcoin's crash to $62,006, but its $1.1 billion coin sale is a balance-sheet story: lenders repaid in full, a bitcoin treasury converting into AI data centers, and a December 31 lease deadline that decides the stock.

    Data Center

    Rackspace signed a $380 million Together AI deal to buy Nvidia GB300 racks; no lender has committed

    The definitive agreement looks like a win for Rackspace, but the company said the GB300 hardware will be financed separately and no lender commitment exists yet. Until that loan closes, the $610 million AI book and the megawatt target behind it are conditions to be met, not numbers to book.

    Data Center

    Everpure CEO and co-founder trusts sold $17 million eight days before Wednesday's earnings report

    Forms filed November 12 show $17.1 million of insider sales on November 10, at $98.88 to $104.75, about a third below the October peak and eight days before the November 18 report. The report has to reconcile a 50 percent growth call from Guggenheim with a company that burned $136 million of operating cash last quarter.

    Data Center

    Gartner sees $4 trillion of AI spending in 2027, but a positive AI return now costs 18 times more

    Gartner's own release credits part of the server bill to memory-price inflation, and its analysts told chief information officers this week that positive returns now cost 18 times more to reach than two years ago. Anyone marking AI vendor revenue against the first number has to price the second.

    Subscribe to TheInference for free
